Using the HydroFoamer transforms your pipeline project in many ways: cost, time and risk.
To fully realise the impact of using HydroFoamer requires a holistic understanding of the pipeline element of a project. That is described more fully in the section ‘x’.
Important Disclaimer: Each project is individual, and exact pricing is governed by factors such as pipeline length and diameter, ease of access, full geotechnical stability requirements, local legislation, weather / geography and the number of bends that require stabilisation. These estimates assume a set of standard engineering requirements that will differ from project to project, and do not take into account possible extra costs, such as mobilisation to extremely remote areas, variations in raw material costs such as fuel and PU components, which are approximately those available in the US at the time of publishing, or the extra costs of consultancy that may be required to comply with local legislation. No rights or expectations can be attached to these figures.

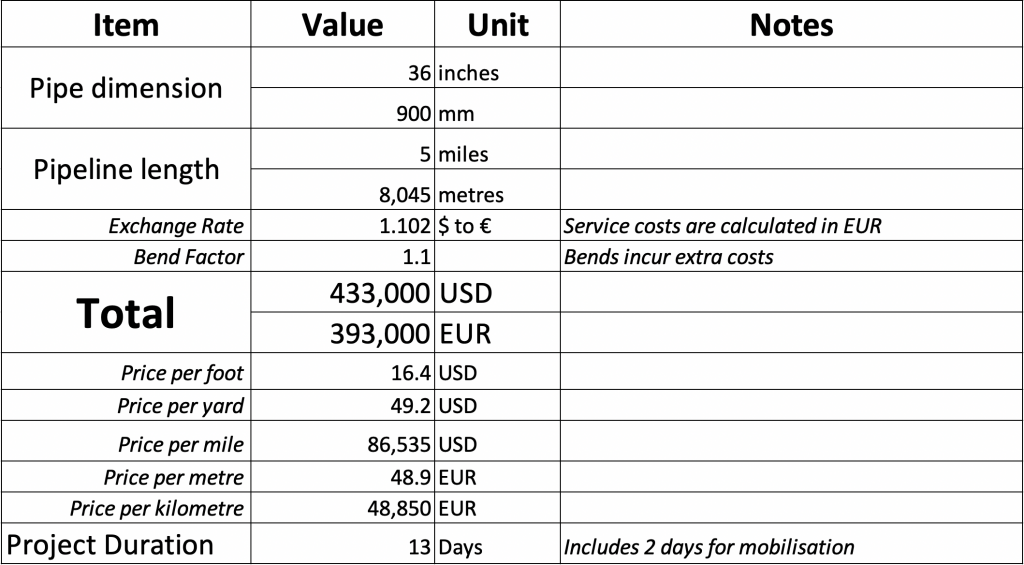

Typical Costs for 36″ / 900mm, 5 mile / 8km Pipeline
This project would be typical for a hydropower or water GRP pipeline in terrain not exceeding 15° of slope.

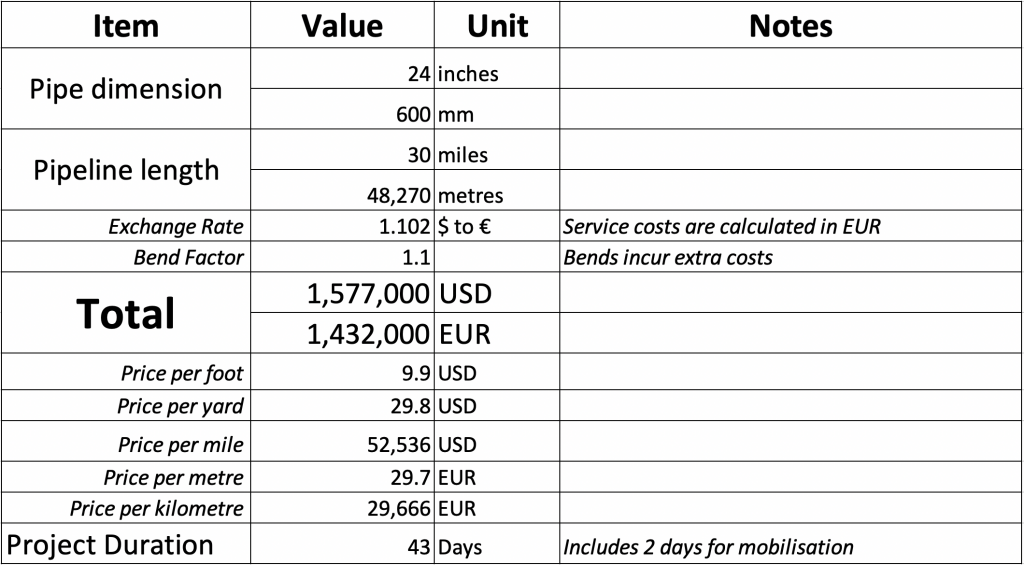

Typical Costs for 24″ / 600mm, 30 mile / 48km Pipeline
This project would be typical for oil & gas welded steel pipeline in terrain not exceeding 15° of slope.
